WEST GOFORTH ROAD reconstruction

Project Status

This project will include a full-depth asphalt pavement reconstruction of West Goforth Road from S. Loop 4 to IH-35. Additional improvements include:

  • Widening the existing 2-lane roadway

  • Adding sidewalks and cycling accommodations

  • Improving drainage along the roadway

Reconstructing West Goforth Road will accommodate bike, pedestrian, and vehicle mobility while minimizing impacts to natural community environment. During the preliminary and final design phases, the City of Buda will coordinate and engage with potentially impacted residents, business, and property owners to participate in the planning process.

Contracted Firm: Freese & Nichols

Current Status:

  • Freese and Nichols, Inc. refined the preliminary design of the W Goforth Project in February 2024. The design was presented to City Council on Feb. 20, 2024. The Council’s Mobility Committee reviewed the proposed design on Mar. 21, 2024 to further evaluate the project. The proposed design was presented to Council for further consideration on Apr. 16, 2024.

  • City engagement with property owners along W Goforth Road occurred in early May 2024 to ensure impacted property owners are aware and informed of the project and its associated requirements regarding easements, right-of-way, drainage, utilities, and property impacts. A virtual open house was released on May 16 and was open through June 13, 2024 to inform the public of the proposed project and receive input and feedback. An in-person public meeting was held on Jun. 11, 2024 to give the public additional opportunities to view and provide input on the project. From these meetings, the City and design team gained the insight and input for consideration for planning and design of the W Goforth Road improvements.

  • On June 18, 2024 the public feedback was presented to the Buda Bond Oversight Committee and City Council. The design team received input and revised the preliminary design to address comments. Three modified preliminary alternatives were presented to Council on August 6, 2024 and Council voted to move forward with alternative 2. 30% design began in October 2024.

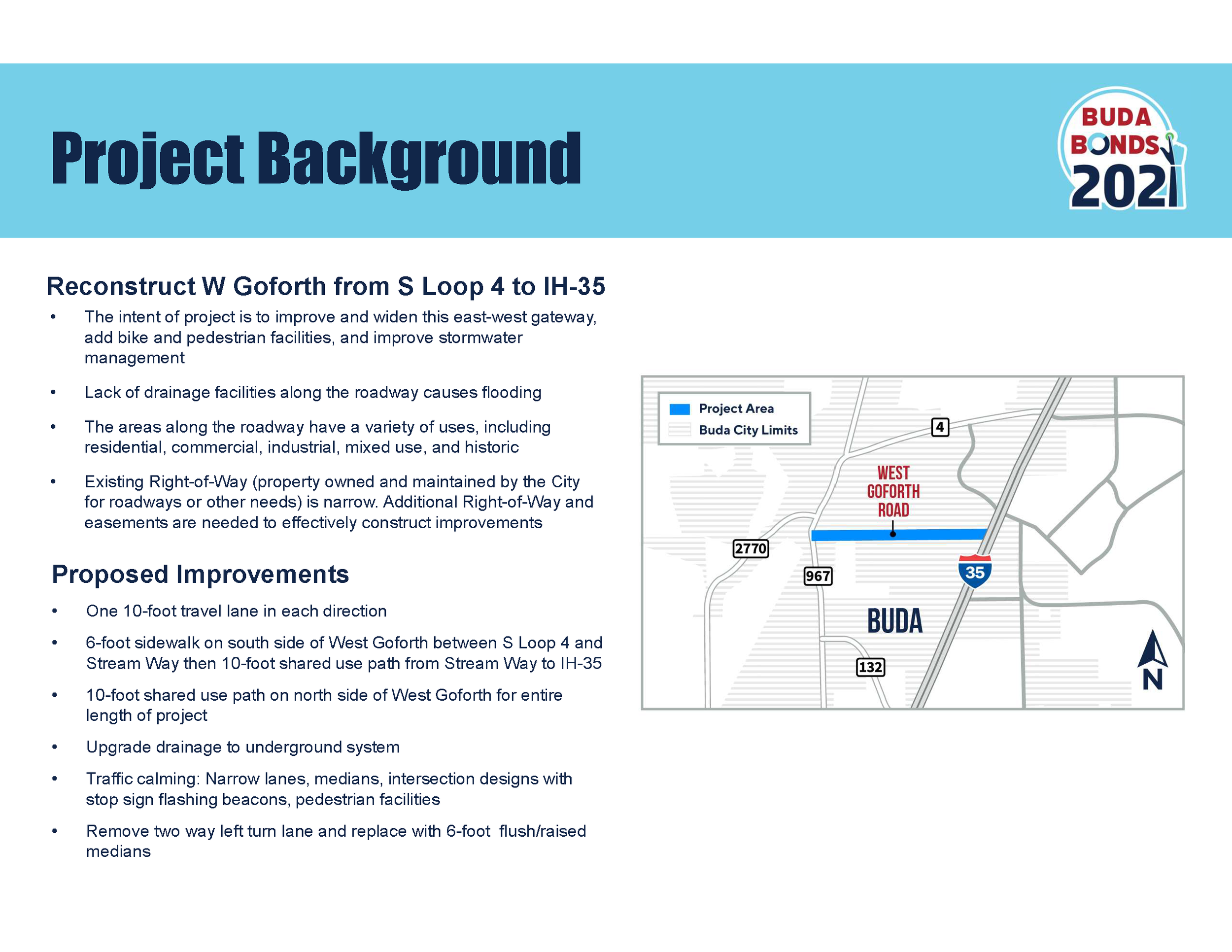

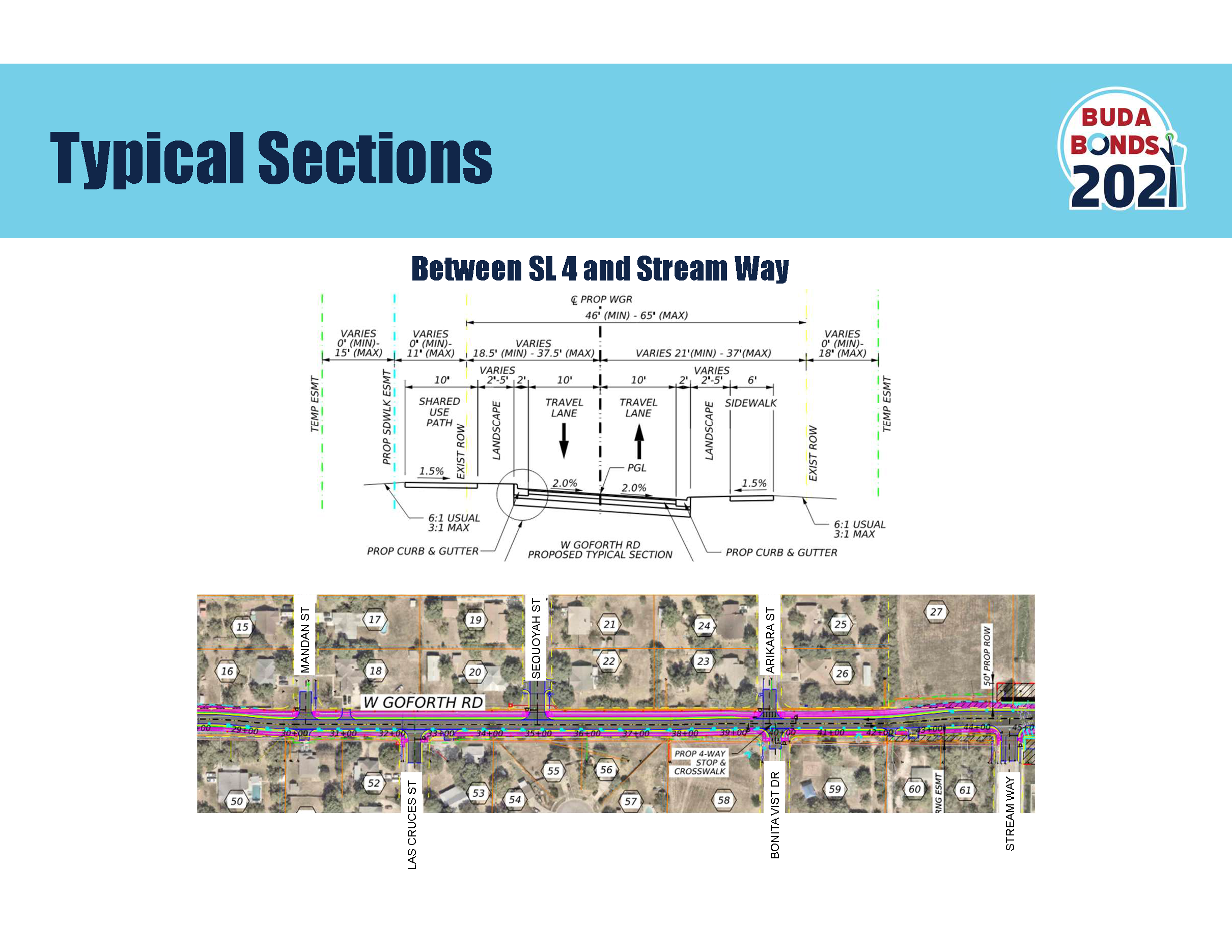

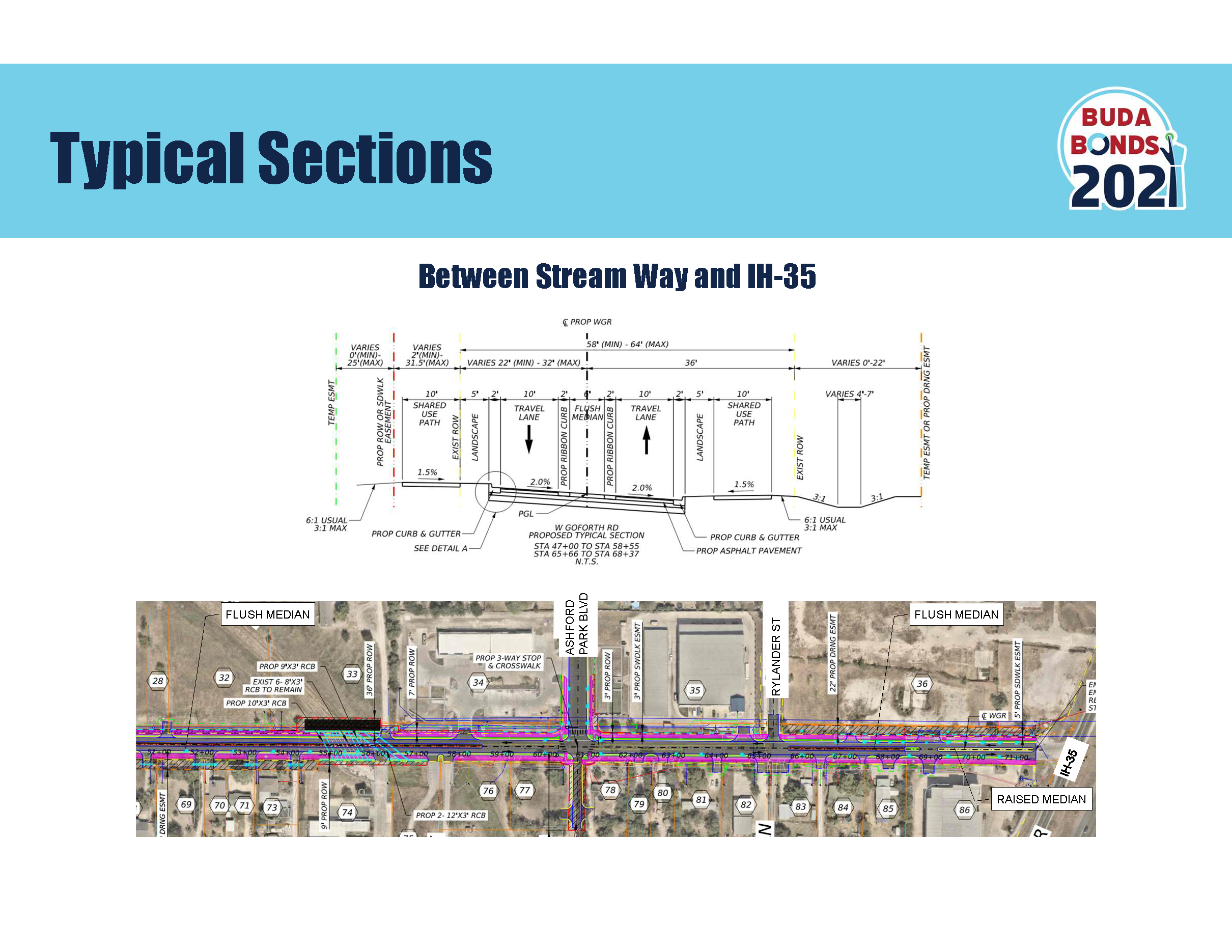

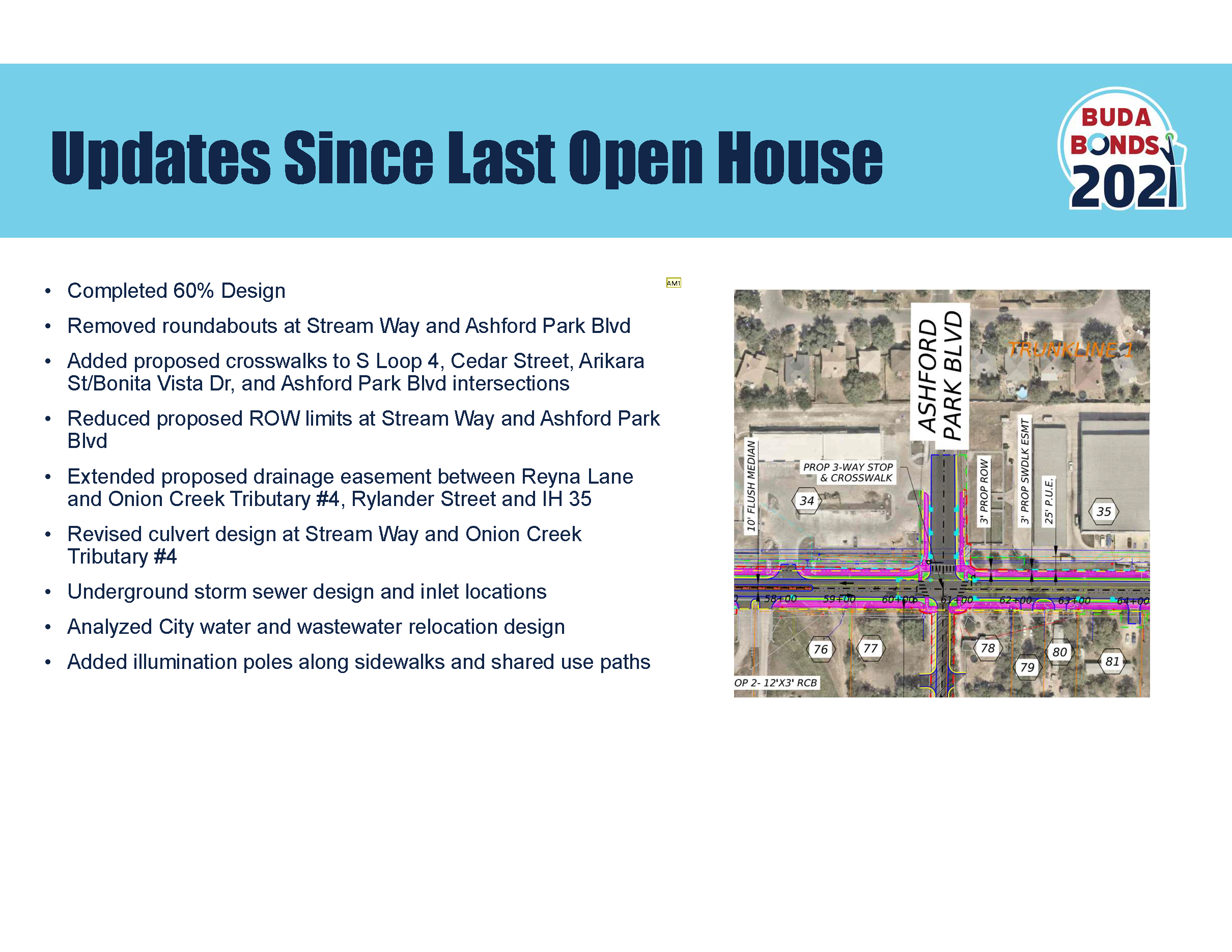

  • On November 19, 2024, the City Council approved the conceptual design (image above) of the project that optimizes the roadway requirements including drive lanes, landscape buffers, sidewalks on the north and south sides, drainage, tree protection, and the standards outlined in the Buda Unified Development Code, Transportation Mobility Master Plan, and the Trails Master Plan.

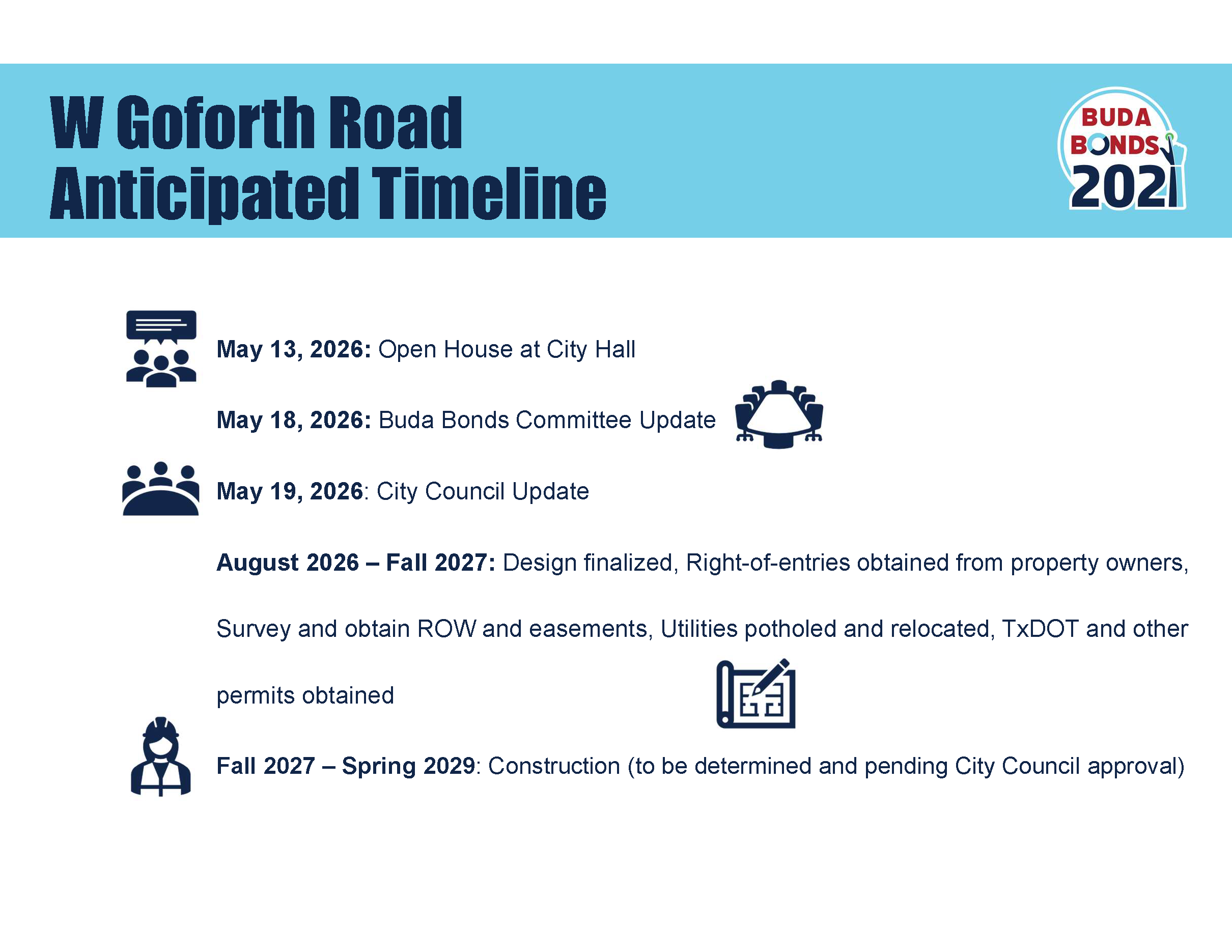

  • On April 29, 2025, the public was invited to an open house at Buda City Hall to see the updated project details and provide input. On June 5, 2025, City Council will consider the updated 30% design of W Goforth Road along with the public feedback. Final design plans will begin Summer 2025, but timing of construction will depend on the right-of-way and easement acquisition process.

  • In May 2025, Council will consider the updated 30% design of W Goforth Road.

  • The 30% design was approved by City Council with direction to the designers to remove both proposed round-a-bouts, look into other traffic calming measures at intersections, decrease truck traffic west of Stream Way, and prioritize drainage improvements. Final design plans will begin Summer 2025, but the timing of construction of the project will depend on the right-of-way and easement acquisition process.

See previous updates ››

Bond Amount: $20,900,000
